A change order records an agreed adjustment to work that is already governed by a project contract. It may add or remove scope, revise the price, extend the completion date, or combine those effects. The useful question is not simply “what changed?” but “what is different from the agreed baseline, who accepted it, and what follows?” Treat this collection as project change-order material, not as an office form for updating personal details.
Try the Business Purchase Order Templates when you need a variation, or move on to the Smart Weekly Budget Templates and the Top 14 Decision Tree Templates.
Anchor the change to the existing contract
Identify the project, site, contracting parties, contract date, and change-order number. Refer to the current approved scope and the drawings, specifications, or earlier changes affected. A description such as “extra work as discussed” gives the next reviewer too little information to determine whether the item was already included.
Keep proposed, authorized, and completed changes distinguishable. A request for pricing is not the same as permission to proceed. Check the contract’s change procedure, including who can authorize work and how notices must be delivered. A supervisor’s involvement in a site discussion does not by itself establish that the supervisor may alter the contract price.
Look for room to explain scope, cost, and time
The previews cover construction, subcontractor, engineering, and other project contexts. Inspect the space available for a detailed scope description, price breakdown, schedule impact, and approval record. A compact form may work for a simple substitution but become unreadable when a change affects several trades or drawings.
Some samples are framed as requests or contemplated changes. Use that distinction deliberately rather than converting a pending request into an approved order by changing only the title. Retain enough room for attachments where the detail cannot fit on one page. Do not assume that a sample’s routing, price fields, or approval positions match your contract.
Check the FREE Change Order Templates Below

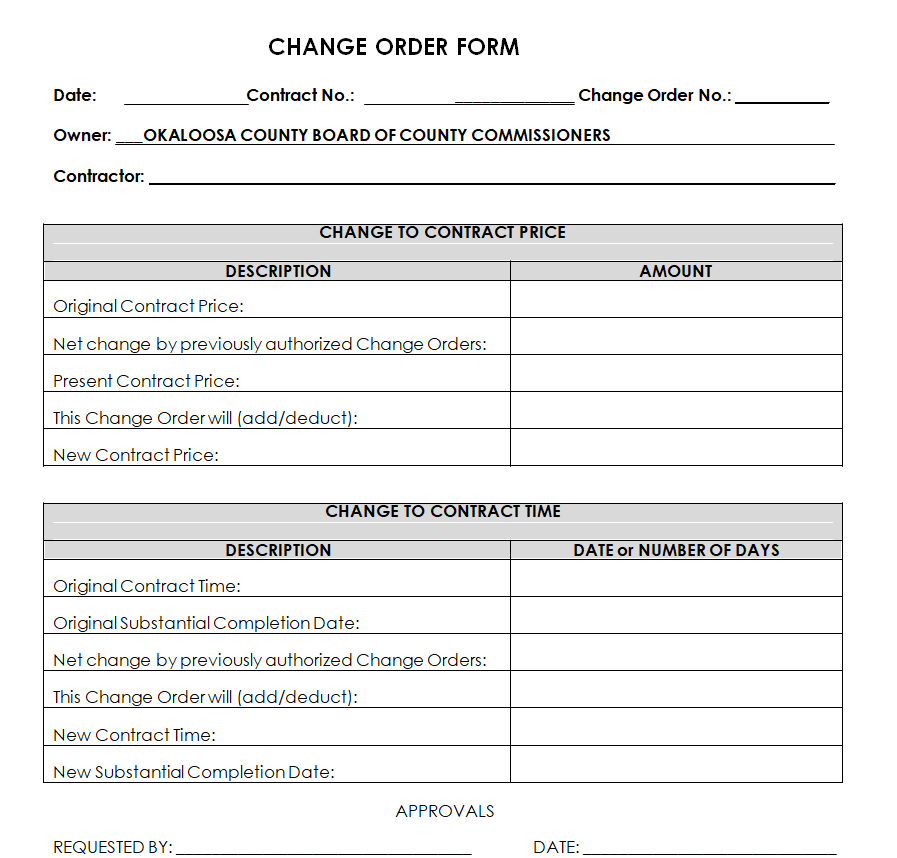

Contract Change Order Template

File Size: 25 KB

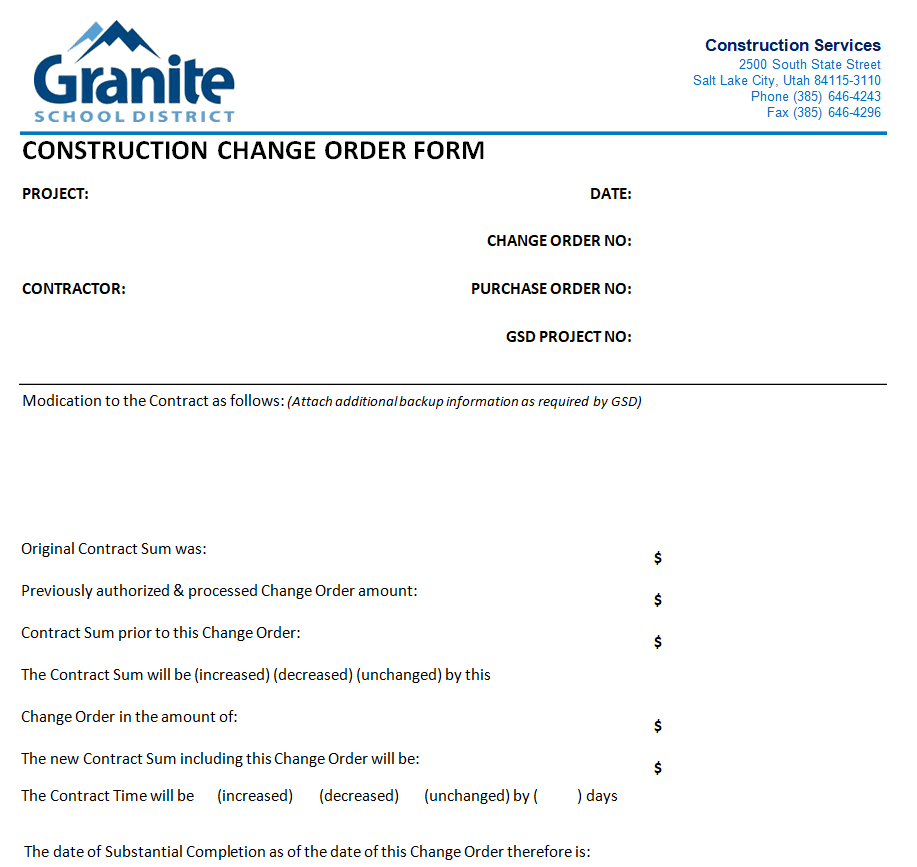

Construction Change Order Form Template

File Size: 16 KB

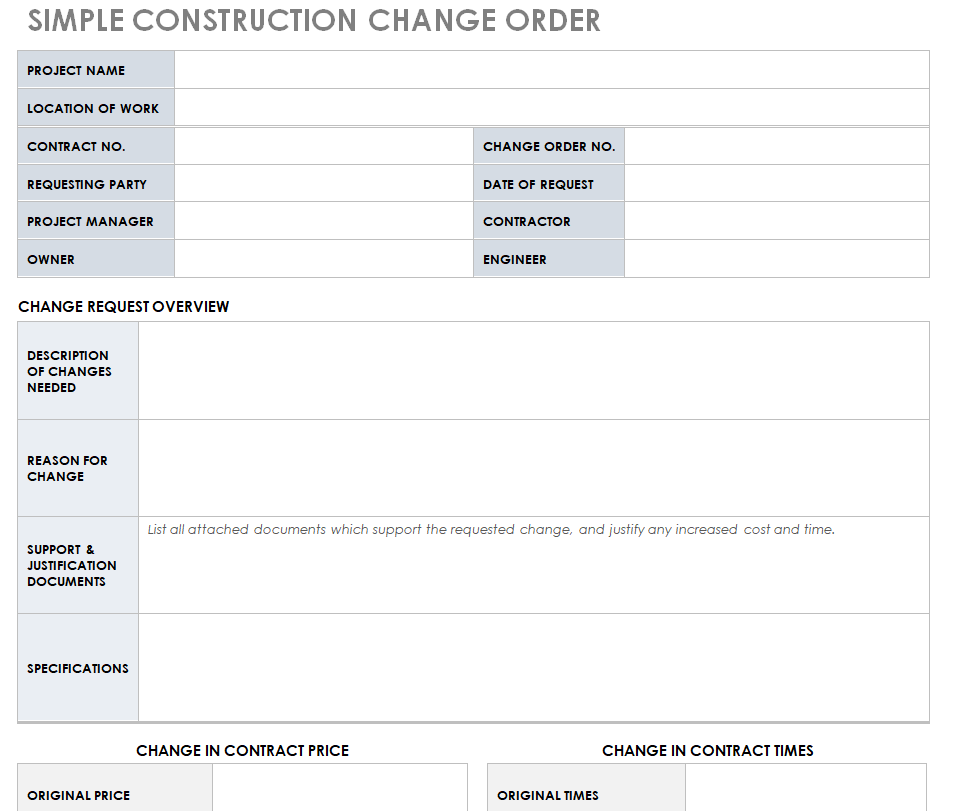

Simple Change Order Form Word Template

File Size: 04 KB
Standard Change Order Form Template

File Size: 126 KB

Purchasing Department Change Order Authorization Form Template

File Size: 54 KB
Dining Hall Change Order Form Template

File Size: 02 KB
Fillable Change Order Form Sample Doc

File Size: 27 KB
Company’s Change Order Template

File Size: 04 KB
Best Change Order Form Word Template

File Size: 05 KB
Engineering Change Order Example in MS WORD

File Size: 24 KB
Sample Change Order Form Template

File Size: 15 KB

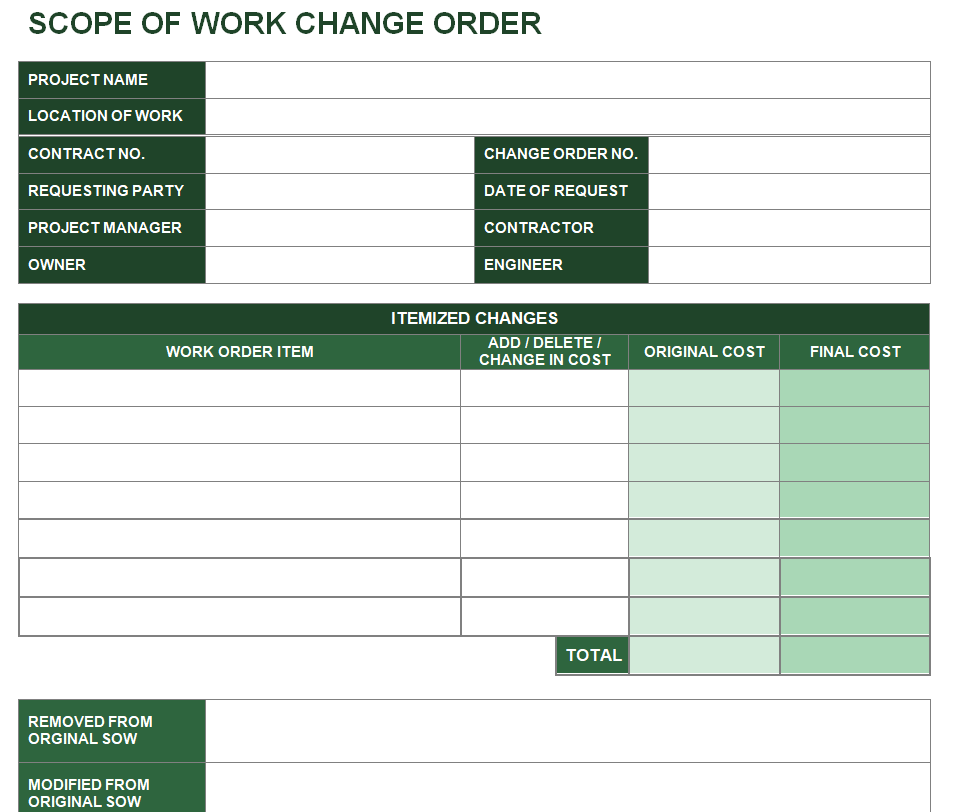

Scope of Work Change Order Doc Template

File Size: 23 KB

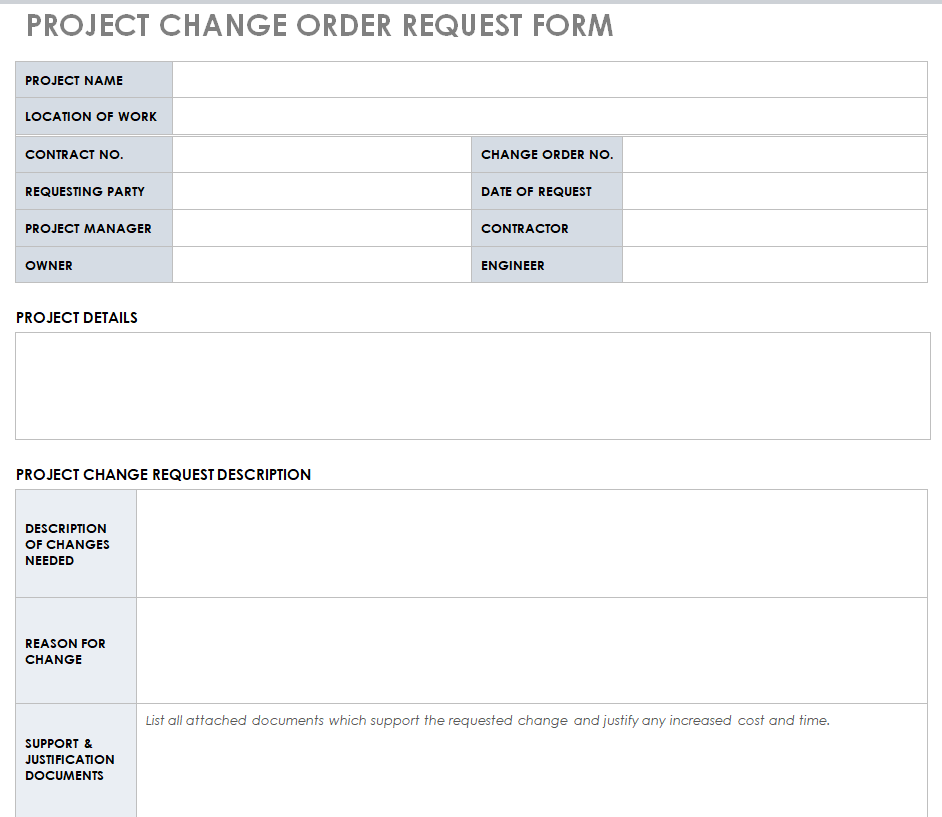

Contemplated Change Order Template

File Size: 15 KB
Free Printable Change Order Form Sample Doc

File Size: 56 KB
Customizable Change Order Form Template

File Size: 23 KB

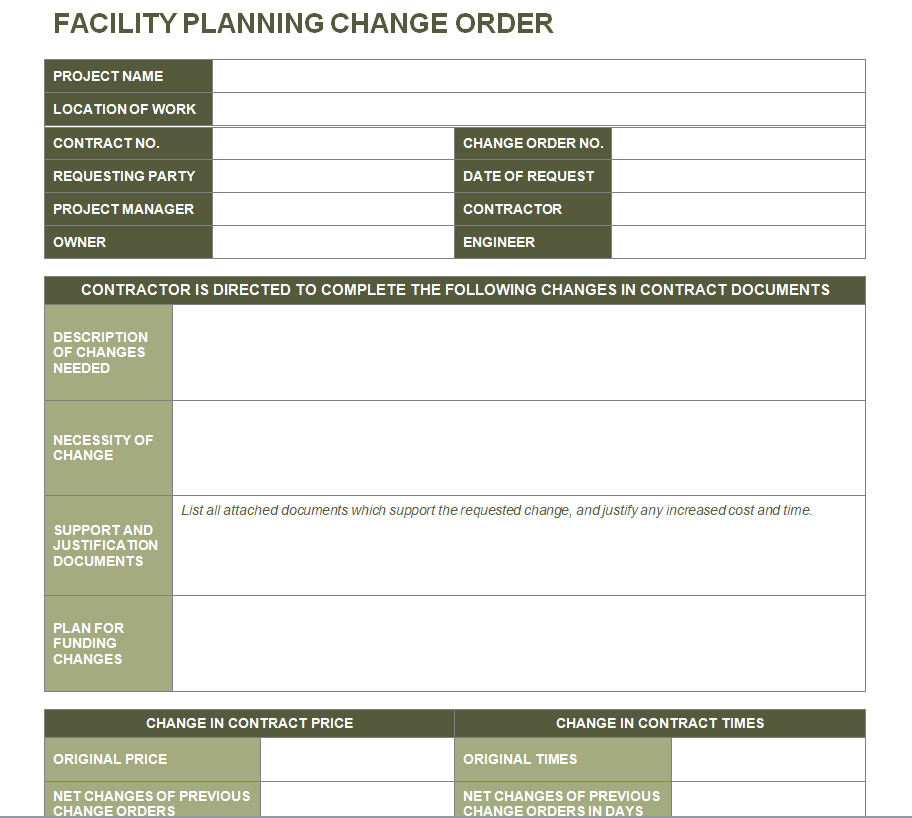

Facility Planning Change Order Word Template

File Size: 22 KB
Describe the difference, including what is removed
State the reason for the change and the actual work affected. Identify location, quantity, material, performance requirement, and relevant drawing revision where applicable. Describe additions and deletions together so a substitution does not accidentally charge for both the original item and its replacement.
For example, replacing one specified finish with another should identify the rooms, the new specification, and any credit for omitted work. Record exclusions and interfaces with other contractors. If a design decision remains unresolved, name it as an assumption or pending item rather than writing an apparently final instruction that depends on information no one has supplied.
Present the commercial effect without disguising allowances
Show the proposed addition or deduction and its basis. Separate labor, materials, equipment, subcontract costs, and permitted markups where the agreed pricing method calls for that detail. Identify allowances and estimates as such, including how they will be settled. Do not present a budget placeholder as a fixed accepted price.
State the contract amount before the change, the net adjustment, and the revised amount if those figures belong in your process. Add the amounts by hand or check how the document is set up, then verify the arithmetic. Distinguish this order from earlier approved changes and pending requests to avoid counting the same amount twice.
A zero-price change still needs an intelligible record. It may alter access, inspection requirements, or responsibilities even when no additional money is agreed. Write “no adjustment” only after the relevant parties have considered the effect; leaving a cost box empty can mean either zero, unknown, or simply unfinished.
Connect schedule impacts to approval and execution
Identify the affected milestone and the requested or agreed adjustment in days, with the revised date where known. Explain dependencies such as procurement lead time, access, inspections, or completion of another trade’s work. A statement that “time is extended as necessary” leaves the practical consequences unsettled.
Record the approval names, roles, dates, and any conditions. Identify the drawing set or attachment package accepted with the order. After approval, issue the same version to the people carrying out, scheduling, and valuing the work. Update the change register and relevant project records, retaining superseded proposals so the final decision can be traced without confusing them with current instructions.
Questions about change status and supporting records
How should an order handle a price based on measured quantities?
Identify the agreed rate, the quantity basis, and how the final measurement will be established and accepted. Label a provisional quantity and amount as provisional. State the reconciliation process so a working estimate is not mistaken for a fixed total or an unlimited authorization to increase quantities.
What if the work changes but the completion date does not?
Record that no schedule adjustment is agreed for this order, if that is the actual decision. Explain significant assumptions, such as maintained access or prompt approval. Do not leave the time section blank and expect later readers to know whether it was reviewed.
How should revised drawings be attached to the order?
List their identifiers, revision numbers, and dates, and make the references consistent with the scope description. Give all approvers the same package. Where a later drawing replaces one in the approved order, follow the change process rather than silently swapping the attachment.
